Victoria Harbour Wastewater Treatment Plant Capacity Upgrade

The Victoria Harbour Wastewater Treatment Plant is currently operating at maximum capacity under our current Environmental Certificate of Approval with the Ministry of the Environment, Conservation and Parks, and as a result Tay Township is not permitted to allow the building of any new or additional dwelling units in Victoria Harbour, and westward to, but not including, Triple Bay Road until additional capacity is brought online.

Please note this only applies to properties which are connected to or are required to connect to municipal wastewater services, it does not apply to those who are on private septic systems outside of the wastewater collection service area.

On January 16, 2026, Simcoe North MPP Jill Dunlop announced that Tay Township will receive $29,514,145 from the province's Municipal Housing Infrastructure Program's Health and Safety Water Stream (MHIP-HSWS) for the Victoria Harbour Wastewater Treatment Plant Expansion Phase II.  Read the full notice at tay.ca/news

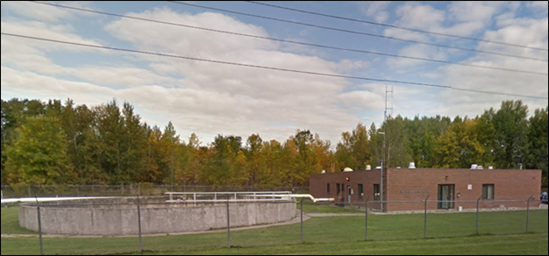

Victoria Harbour Wastewater Treatment Plant

Addressing Capacity Challenges and Environmental Sustainability

The Wastewater Treatment Plant (WWTP) in Victoria Harbour, has been a critical infrastructure asset for the local community since its construction in 1982. Initially built with a rated capacity of 2,364 cubic meters per day (m³/d), the plant has played a vital role in managing and treating wastewater, ensuring that the water entering the harbour meets environmental standards. However, over the years, increasing population growth and urban development in the area have put significant pressure on the plant’s capacity, resulting in a situation that requires urgent attention and upgrading.

As of 2019, the Victoria Harbour WWTP faced a significant issue: its capacity began to exceed the rated limit of 2,364 m³/d. The plant's infrastructure, designed for a smaller community size, struggled to keep up with the demands of a growing population and increasing wastewater volumes. This situation led the Ministry of Environment, Conservation & Parks (MECP) to impose a development ban until the necessary upgrades to the plant were completed.

A development ban is typically a measure taken to prevent further stress on the wastewater treatment system until it is brought up to capacity standards. It is a precautionary approach to prevent potential environmental harm, such as untreated or poorly treated effluent being discharged into local water bodies, which could lead to contamination and affect the ecosystem of Victoria Harbour. The MECP's decision highlights the importance of sustainable development and responsible water management in ensuring that infrastructure keeps pace with community growth.

Expanding the Victoria Harbour WWTP: A Phased Approach to Sustainable Growth

Tay Township has been working diligently with engineers and consultants to address the growing demand for the Victoria Harbour Wastewater Treatment Plant (WWTP) through an innovative double-phased expansion strategy. With the population in the area steadily increasing and the plant operating beyond its initial capacity, these upgrades are essential to ensure the plant can meet the future needs of the community while adhering to environmental standards.

Phase 1 of the expansion was successfully completed in 2017, marking a significant step in the plant's evolution. Phase 2 is set to begin in late 2026, with an increased daily treatment capacity that will ensure the facility is capable of handling future growth.

The first phase of the Victoria Harbour WWTP expansion focused on essential improvements to enhance the plant’s efficiency and reliability. Key upgrades included:

  • New Standby Generator: This upgrade ensures that the plant can continue operating during power outages, minimizing downtime and ensuring uninterrupted service.
  • Sand Filter Replacement: The replacement of the sand filters improved the plant’s filtration system, allowing for better treatment and efficiency in removing solids from the wastewater.
  • New Headworks Building: This addition provided a more robust and efficient system for preliminary treatment of wastewater, ensuring that large debris and solids are effectively removed before further processing.
  • Installation of Ultraviolet (UV) Disinfection Units: These units use UV light to disinfect treated water, reducing the reliance on chemicals and improving the quality of the effluent before it is discharged into the environment.

These upgrades laid the groundwork for Phase 2, addressing immediate capacity issues and ensuring the plant could continue to operate effectively for the time being.

Looking ahead, the second phase of the expansion project will begin in late 2026 and promises to significantly increase the plant's capacity. The new average daily flow is expected to rise to 3,550 cubic meters per day (m³/d), allowing the plant to meet the needs of a growing community. Key elements of Phase 2 include:

  • New Biosolids Building: This facility will manage the treatment and disposal of biosolids, ensuring that waste products are properly handled and processed in an environmentally sustainable way.
  • Two New Aeration Tanks and Two Aerobic Digesters: The addition of these tanks and digesters will enhance the biological treatment process, increasing the plant's ability to break down organic matter in the wastewater.
  • Upgrades to Wet Well Lift Pumps: These improvements will ensure that wastewater is effectively lifted and transported through the treatment plant, increasing operational efficiency.
  • New Secondary Clarifier: A 16-meter diameter secondary clarifier will improve the settling process, allowing for more effective separation of solids from treated water.
  • Replacement of Aeration Blowers: The plant will see the replacement of three existing aeration blowers, which are crucial for introducing oxygen into the treatment process and promoting the growth of bacteria that break down organic matter.
  • HVAC System Upgrades: These upgrades will improve air circulation and temperature control within the facility, ensuring that the plant operates efficiently and safely.

Funding Challenges and the Path Forward

While the expansion of the Victoria Harbour WWTP is crucial for Tay Township’s long-term growth and environmental sustainability, the construction work for this project relies heavily on securing adequate funding. Unfortunately, the tender costs for the project came in over the projected budget, creating a financial shortfall that must be addressed before Phase 2 can proceed.

On January 16, 2026, Simcoe North MPP Jill Dunlop announced that Tay Township will receive $29,514,145 from the province's Municipal Housing Infrastructure Program's Health and Safety Water Stream (MHIP-HSWS) for the Victoria Harbour Wastewater Treatment Plant Expansion Phase II.  Read the full notice at tay.ca/news.

Timelines and Future Considerations

While the planned upgrades for Phase 2 are a major step forward, it is important to note that the timelines for the project are subject to change. As with any large infrastructure project, factors such as budget considerations, unforeseen delays, or changes in regulatory requirements can impact the final schedule. However, the projected timeline for the start of Phase 2 is late 2025 with funding considerations, with the expectation of increased capacity and enhanced treatment processes by the time the expansion is complete.

  • Township of Tay will be receiving $29,514,145 from the province's Municipal Housing Infrastructure Program's Health and Safety Water Stream (MHIP-HSWS) for the Victoria Harbour Wastewater Treatment Plant Expansion Phase II. Read more at tay.ca/news
  • The Township applied for government funding under the Housing-Enabling Water Systems Fund (HEWSF) in February 2024. This application was unsuccessful.
  • The Township applied for the second round of funding under the HEWSF II funding in November 2024. This application was unsuccessful.
  • The Township applied for the Canada Housing Infrastructure Fund (CHIF) March 31, 2025. This application was unsuccessful.
